Tenant Satisfaction Survey Sept-Nov 2005
Neetara carried out a survey of tenant satisfaction with
the major refurbishment works being carried out by
Partners,
the PFI contractor.
Interviews were conducted with tenants at 46 households,
mostly face-to-face and with some self-completion. The
interview assessed:
- Satisfaction with Partners,
the works process and the quality of work.
- Areas and means of improvement
The main results, recommendations and conclusions are shown below.

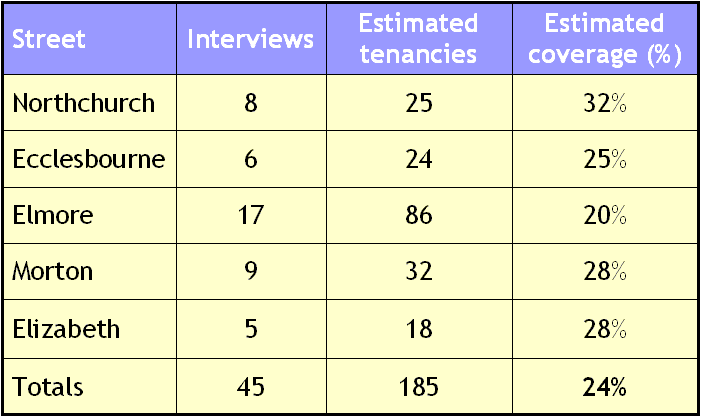

Sample description
Responses by location

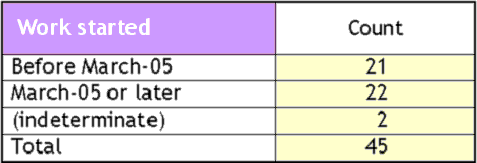

Works start date

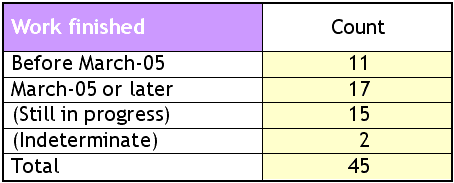

Works completion date or status

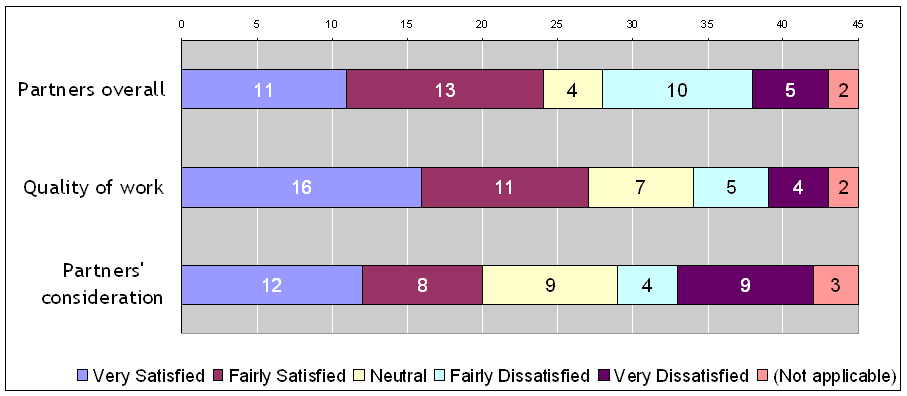

Tenant Satisfaction

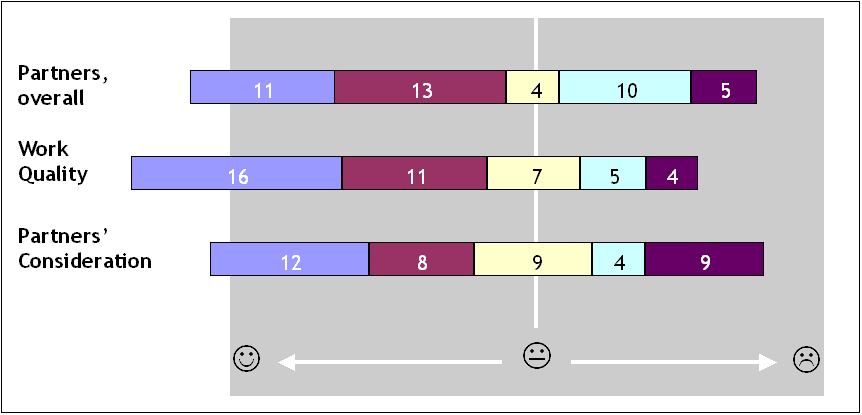

Overall satisfaction
Tenants were asked to summarise satisfaction in three areas:
- Overall satisfaction with Partners
- Overall satisfaction with quality of works
- Partners' consideration for you and your home

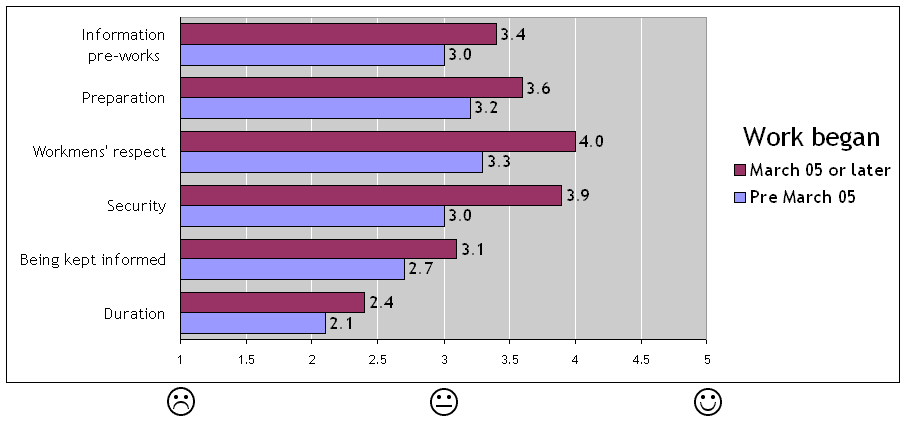

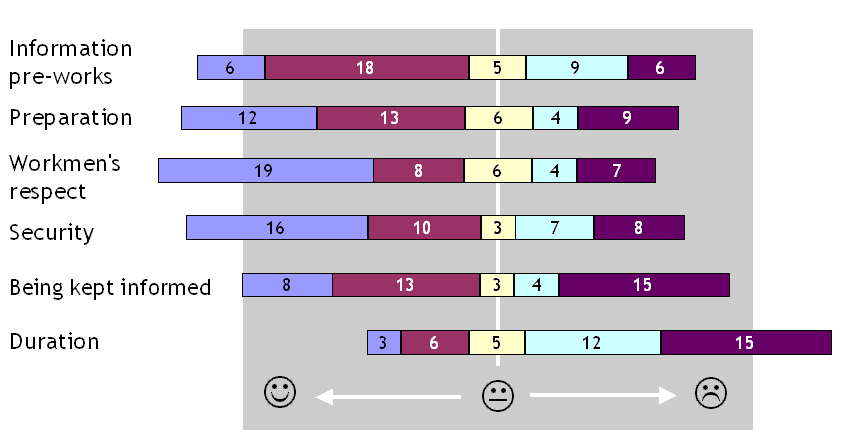

Satisfaction with Works Process
Satisfaction with Works Process by Start date

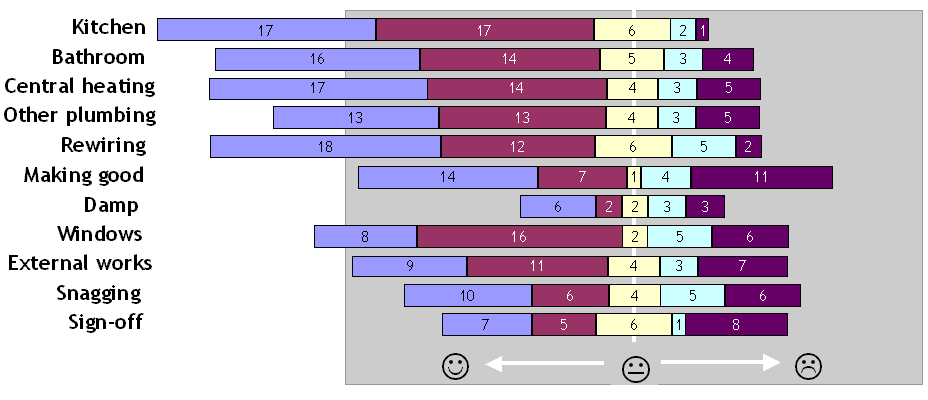

Satisfaction with Works
Complaints

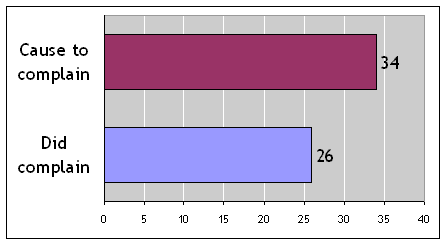

Tenants were asked whether they felt they had cause to complain
to Partners, and whether they actually did.

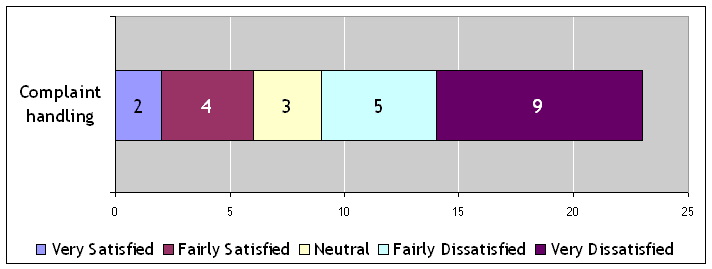

Satisfaction with complaint handling

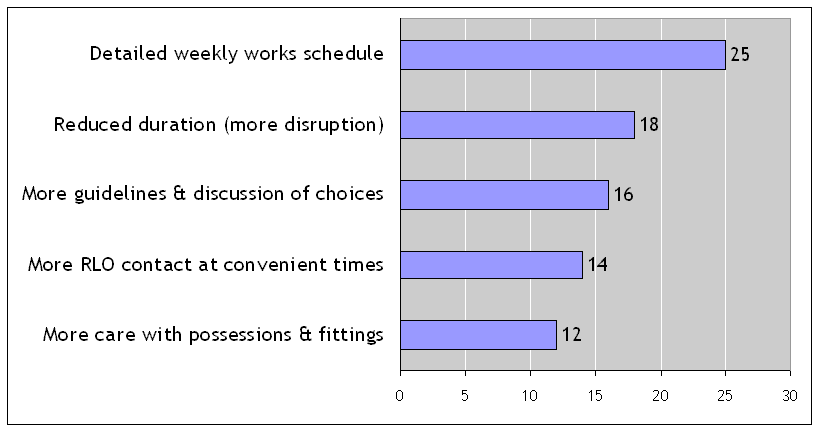

Improvements - top 2
Tenants were asked to select the 2 most important improvements
out of 5:
- "Reduce the length of time the works take (more disruption short
term, but finished more quickly)"
- "Take greater care with possessions / fittings / flooring during
the works"
- "Provide clear guidelines / discussion about the refurbishment
areas where choices and preferences can be made"
- "Provide a detailed works schedule (what will be done in your
home, updated on a week by week basis)"
- "More regular contact with Resident Liaison Officer (RLO), at
times to suit you"
Recommendations
Communication
- Provide good verbal and written information
- Consult tenant, confirm choices/preferences that can be
accommodated and implement
Project Planning
- Duration. One size does not fit all; assess likely duration
of works case by case. Give tenants realistic duration
estimates - manage expectations
- Do works in best order, and with priority to infrastructure
(ceilings, walls, pipes, wiring)
- Unique opportunity to 'get things right', reduce burden on
repairs service, as major works are signed off (30-year
contract)
Conclusion
- Dissatisfaction is mostly with 'process' rather than 'work'
(mean satisfaction with Process 3.1, Works 3.5)
- Priority areas
- Communication: detailed works schedule
- Duration, 'making good' and sign-off
- Complaints handling
- Post-March 05 looks better but expect a sting in the
tail as duration - the area of highest dissatisfaction -
increases (15 still in progress at time of survey).
